S.D. Highway 11 North of Brandon

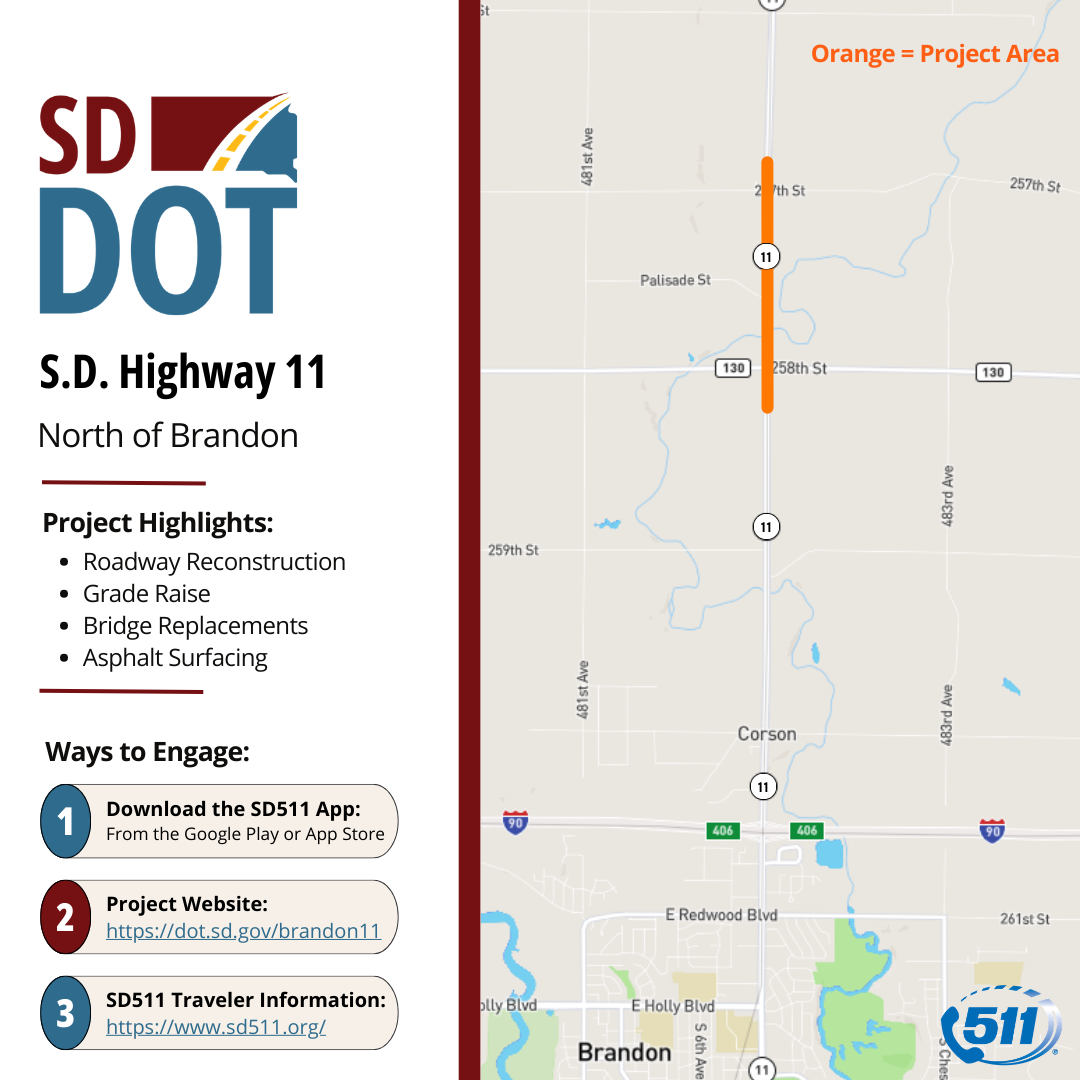

S.D. Highway 11 North of Brandon Project Location Map

Project Summary:

The project will reconstruct approximately one and one-half miles of roadway, including replacing two bridges over West Pipestone Creek and Split Rock Creek.

The roadway will be raised approximately 10 to 12 feet through the low-lying valley to reduce flooding impacts and improve long-term reliability. Once complete, the new asphalt surface will provide a smoother ride for motorists and help reduce future maintenance needs.

Project FAQ's:

Is this stretch of road getting raised?
When will S.D. Highway 11 be fully closed?
Are the bridges being replaced?
What are expected travel delays during the closure?

Detour Maps:

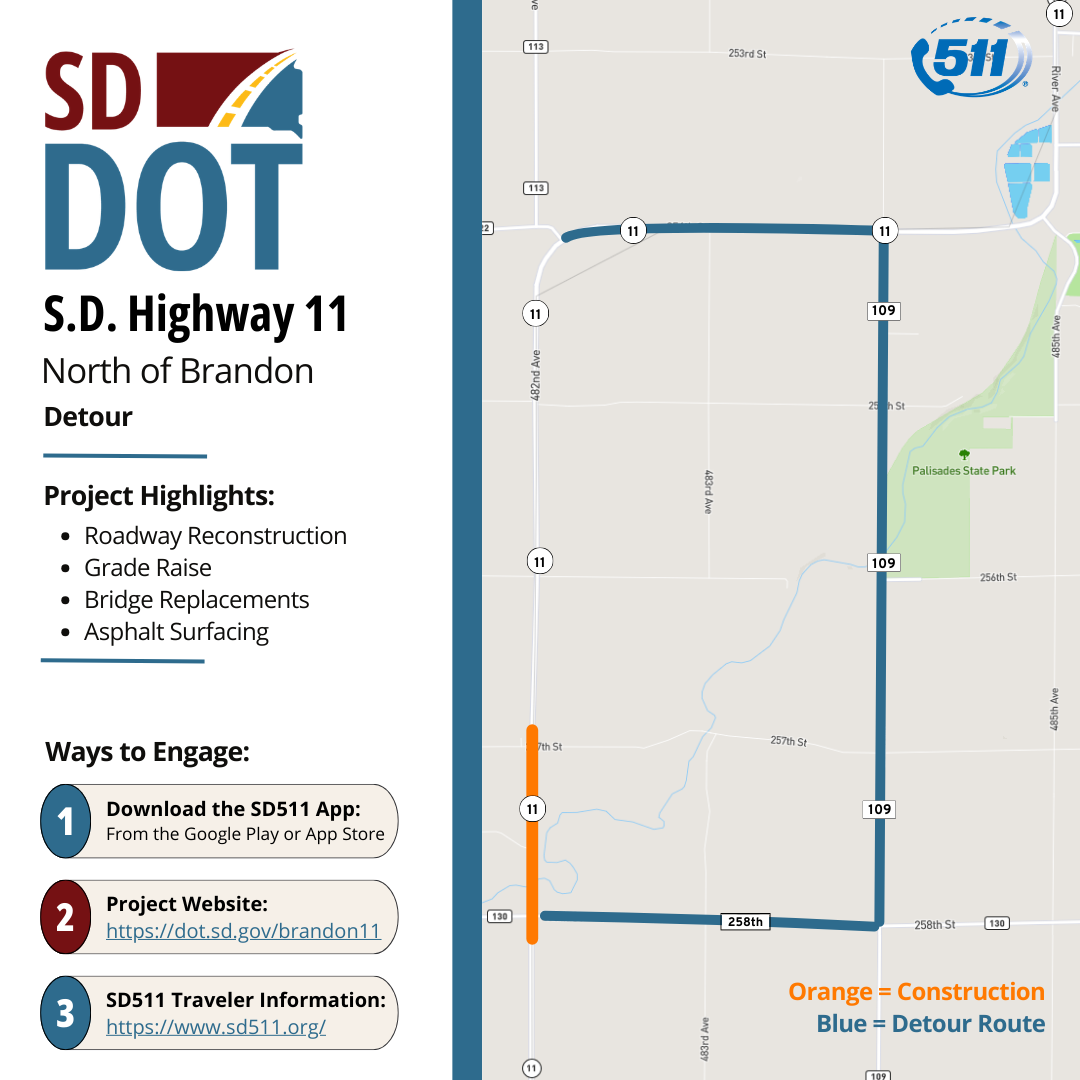

Detour:

S.D. Highway 11 North of Brandon Detour Map

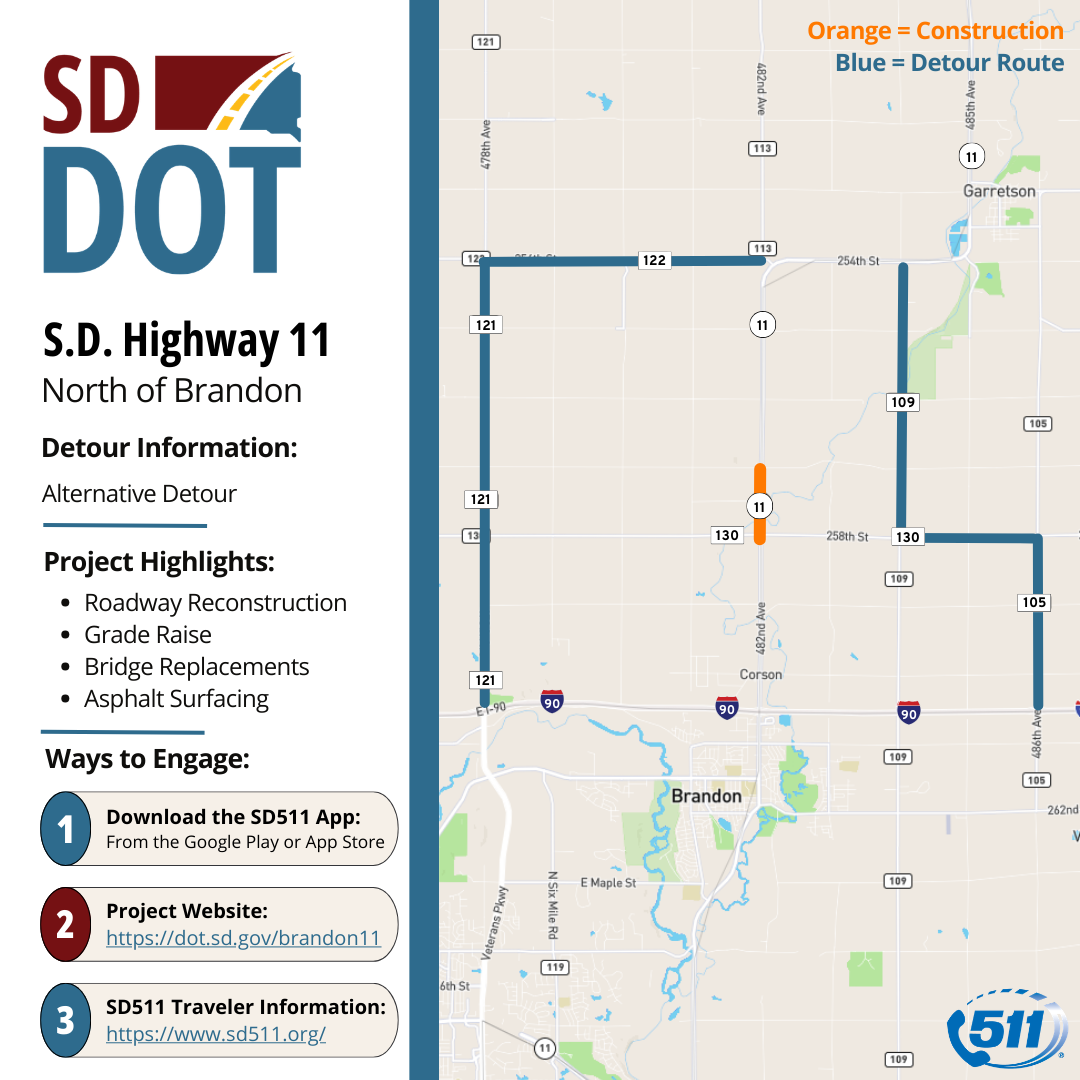

Alternate Detour Map:
S.D. Highway 11 North of Brandon Alternate Detour Map



Project Updates:

April 17, 2026:

Anticipated Work - April 2026:

Contractor crews will continue grading outside the shoulders along S.D. Highway 11, County Highway 130 and 257th Street. Highway 11 and Highway 130 will remain open until after Monday, June 1, 2026, though drivers may see closures at the intersections of 257th Street and Palisade Street before that date.

Multiple utility companies are also working on relocations along Highway 11 and Highway 130.

In March 2026, the contractor began grading outside the shoulders and started hauling borrow material from pits near Knife River. Metal pipe culverts were installed in field approaches and driveways. Utility companies have been relocating gas, fiber and electrical lines.

Project Photos:





PCN: 05V6

Schedule:

  • April 2026 - Summer 2027

Location:

  • S.D. Highway 11 from 257th Street to 258th Street
    Three miles north of Brandon

Travel Impacts:

  • S.D. Highway 11 will be closed from June 1, 2026, through the spring of 2027. Main detour in effect from September 2026 to Spring 2027.

  • Intersection of S.D. Highway 11 and County Highway 130 (258th St.) will be closed from June 1, 2026, to September 2026. The contractor has 70 days for this closure. Please use the alternative detour route.

Benefits:

  • Structure replacement

  • Reduction of flood impacts

  • Resurfacing

  • Reduce future maintenance needs

Estimated Cost:

  • $14.9 Million

Contractor:

  • Runge Enterprises, Inc.

PCN: 05V6
