Interstate 90 and I-29 and I-229 Bridges in Sioux Falls


Project Summary:

Interstate 90 East and West - Interstate 90 and Interstate 29 Interchange over I-29 drainage ditch and I-90/I-229 Interchange over I-229

  • Bridge Deck Overlays
  • Approach Slabs PCC Pavement
  • Signing and Guardrail

Sign Up for Text Notifications:

For updates on MAJOR traffic changes, subscribe to a free text-in service. To subscribe, simply text the keyword listed below to 605-566-4041. Subscribers can unsubscribe at any time.

Text I90Bridges to 605-566-4041

Project Detour Map:

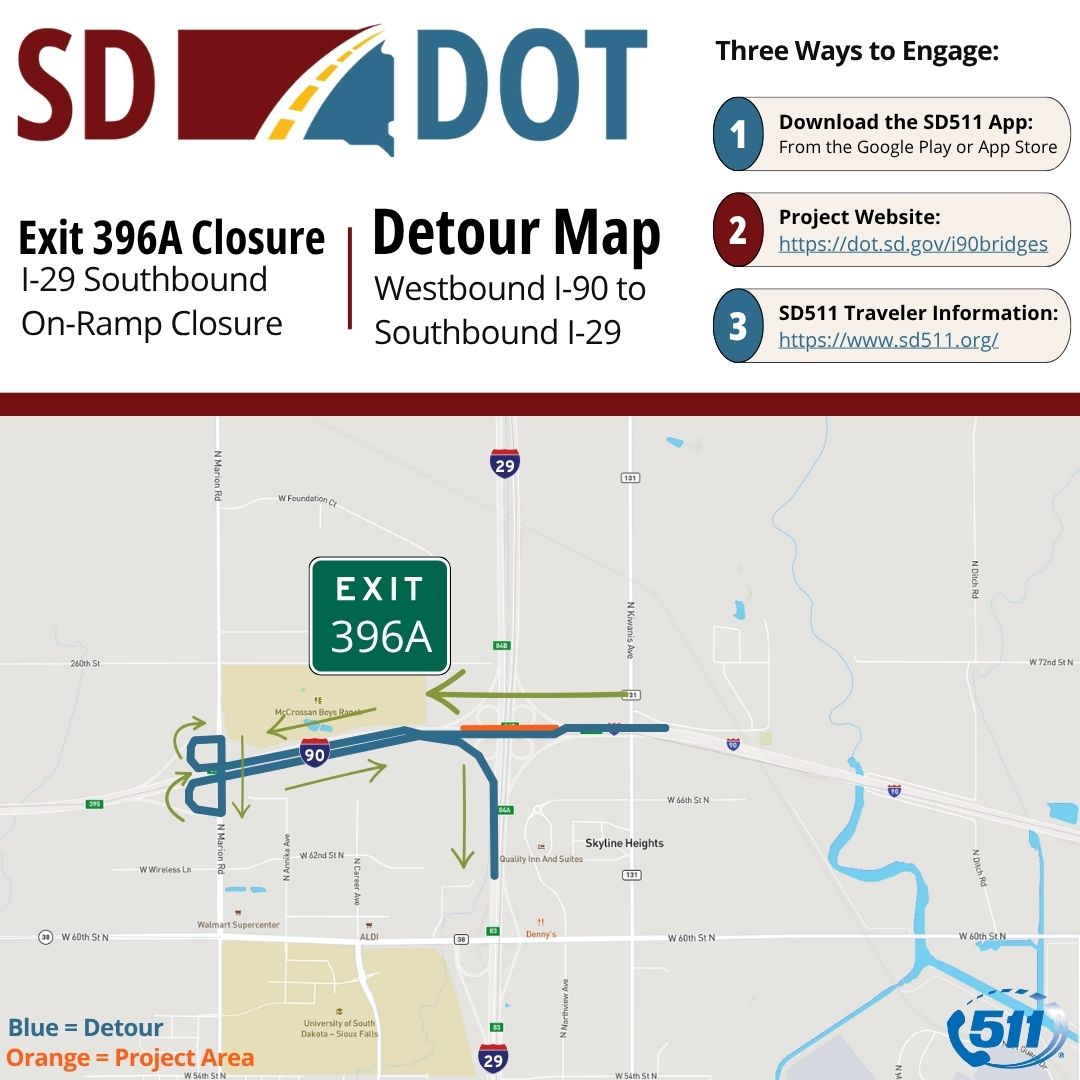

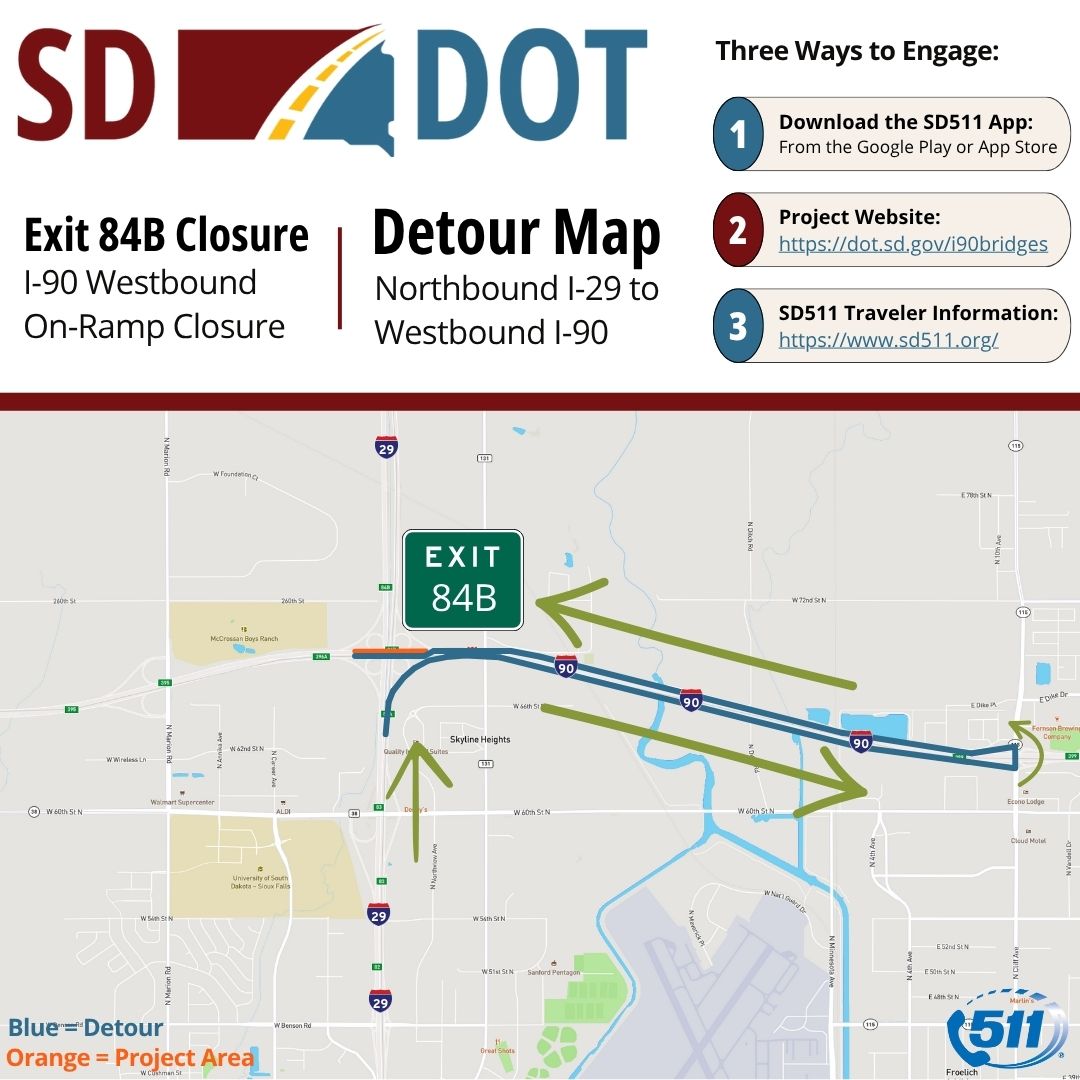

Exit 84B Detour Map.jpg Exit 396A Detour Map.jpg

Project Timeline:

April 2025 - Fall 2025

Project Updates:

Aug. 21, 2025:

July 15–Aug. 15, 2025, Completed work:

Westbound I-90 bridge over I-29

  • Two-way traffic is in place on eastbound I-90 to allow for construction.
  • The north loop ramps at the interchange are closed.
  • The low-slump bridge overlay is complete.
  • Crews continue work on mainline concrete paving, asphalt shoulders, and guardrail.

Anticipated work Aug. 15–Sept. 15, 2025:

Westbound I-90 bridge over I-29

  • Crews will complete mainline concrete paving, asphalt shoulders, and guardrail.
  • Once complete, traffic will be restored and the north loop ramps will reopen.

Project Photos:


Project Contract Amount:

$3.1 Million

Project Contacts:

SDDOT:
Brad Tiede
605-367-5680


Contractor:
Journey Group Companies

STATEWIDE CONSTRUCTION PROJECTS PAGE





PCN: 091T
